Site Logistics & Phasing
Project Phases

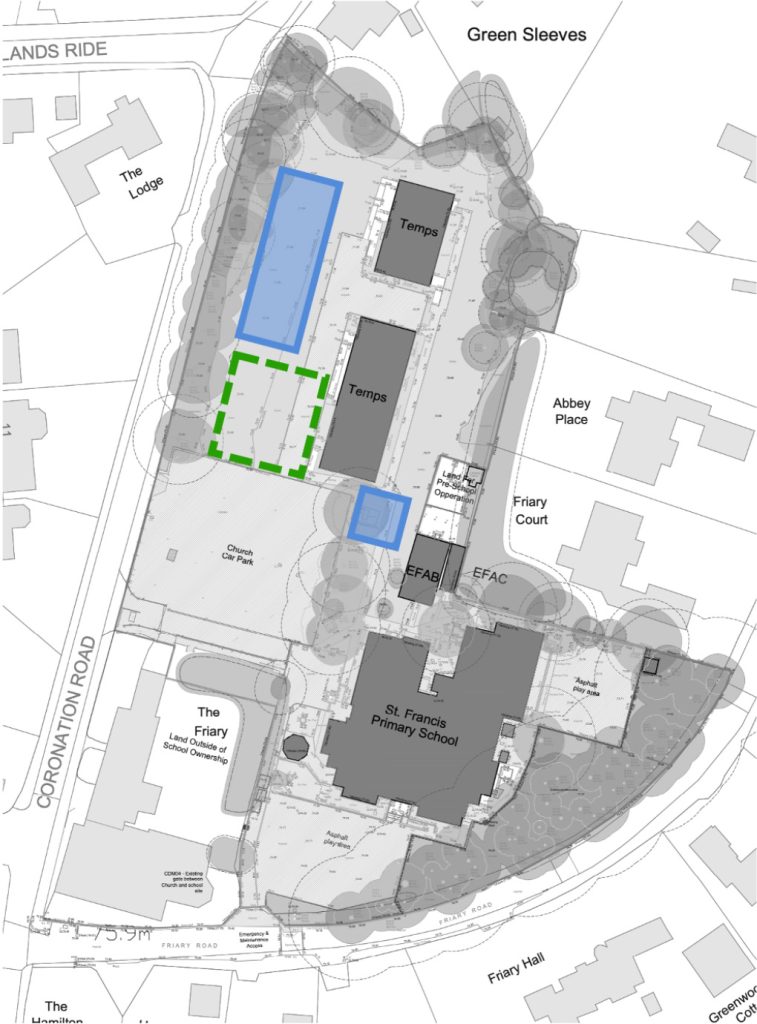

Phase 1 – Spring 2026
- Construction of new temporary buildings and hard play area
- Decanting of school

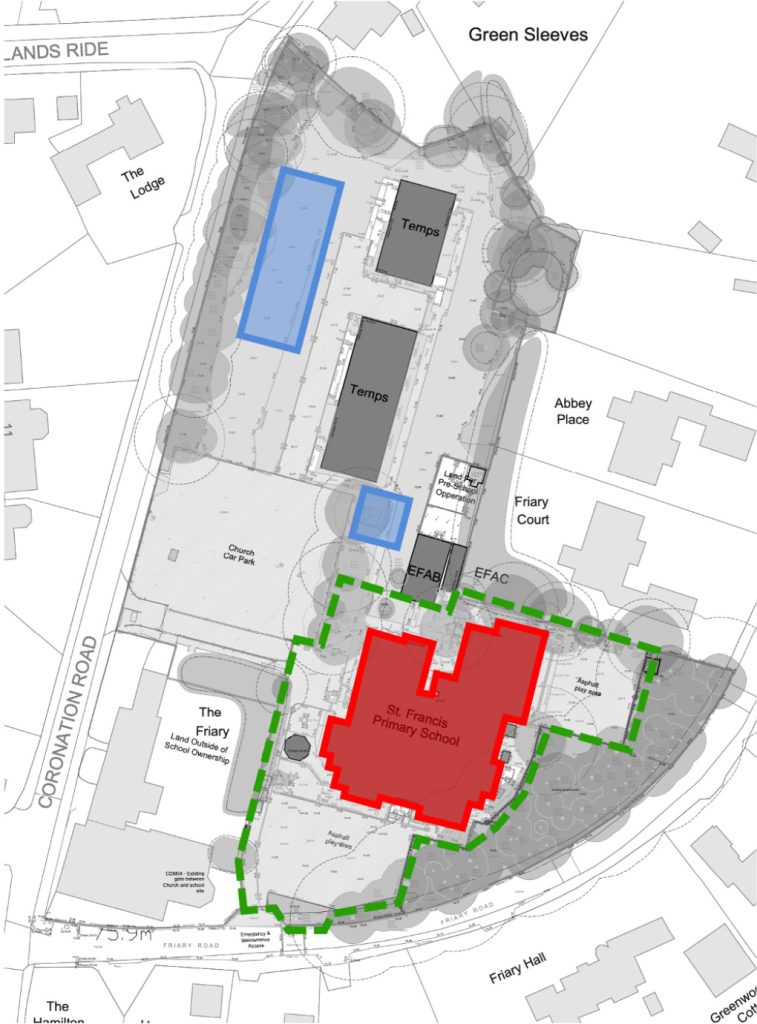

Phase 2 – Spring 2026 / Summer 2027
- Demolition of existing school building
- Construction of new school building with adjacent external areas & landscaping

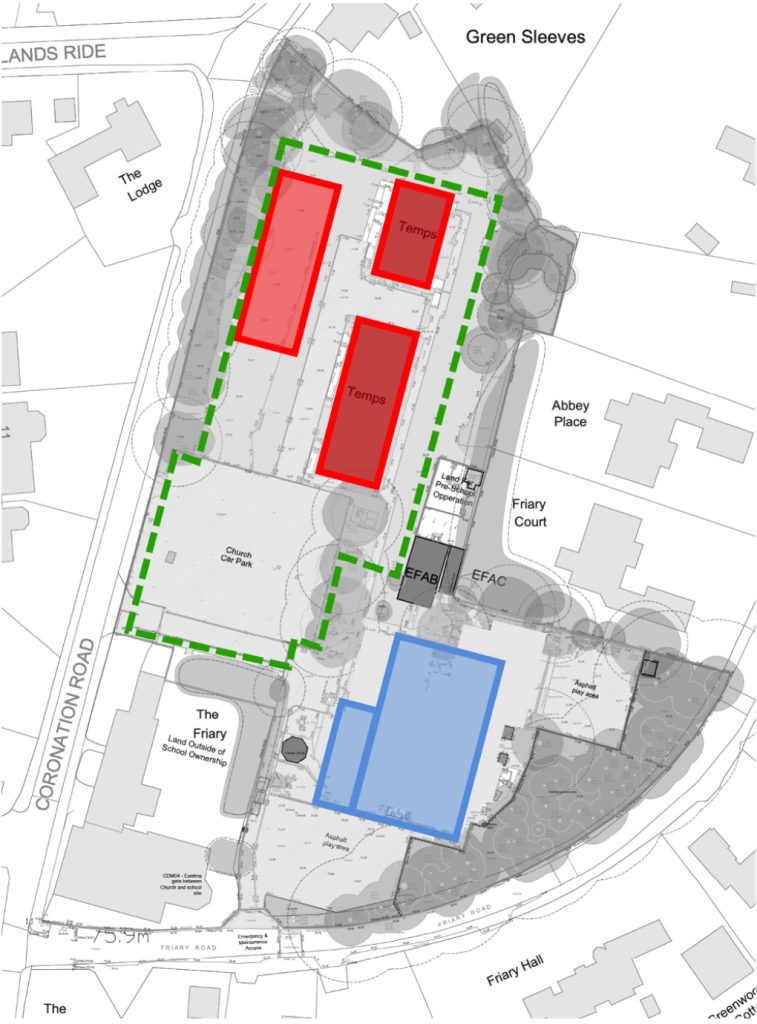

Phase 3 – Summer 2027
- Occupation of new school building
- Removal of temporary buildings
- Construction of Multi Use Games Area (MUGA) and sports pitch
Site Operations
Ongoing co-ordination will ensure consistent standards and that buildability is embedded in the designs. This will support minimal
construction programme, minimise material waste and environmental disruption.
Contractors will ensure that due consideration is taken of the environmental site needs and the needs of neighbouring landowners and occupiers. Typically, this would require controls on site traffic, site hours of operation, site noise and waste management.
- Site working hours
8am to 6pm Monday to Friday
8am to 1pm on Saturdays (only as required). - Main site access/egress off Coronation Road shared with car park.
- Restricted delivery periods during school term.
No deliveries between 8.30am – 9.15am and 2:45pm – 3:15pm. - Site parking for operatives will be off site in local free public car park.
- Disruptive works programmed during school closures or out of hours.
- Traditional build with steel frame, SFS, Brickwork façade, Green flat roofs with solar panel.
|
|
